-
Laporan Sukuk MAKI-MSY06 - 02 Juni 2026
Assalamu'alaikum warahmatullahi wabarakatuh,
Selamat siang, Bapak/Ibu Pahlawan Bangun Negeri.
Terima kasih atas support dan partisipasi Bapak/Ibu semua dalam project MAKI-MSY06.
Alhamdulillah, untuk Factory Acceptance Test (FAT) telah terlaksana pada hari Jumat, 29 Mei 2026 lalu bersama dengan pihak customer. Per saat ini, kami menunggu feedback customer terkait penagihan progress project.
Demikian update untuk project MAKI-MSY06, apabila ada pertanyaan atau hal-hal kurang jelas lainnya, kami persilahkan Bapak/Ibu Pahlawan Bangun Negeri untuk berdiskusi lebih lanjut pada forum
Catatan: seluruh berita, dokumen dan media bersifat confidential hanya untuk forum terkait saja dan mohon agar tidak disebarluaskan
Terima kasih atas support Bapak/Ibu selalu.
-
Subjek: Laporan Perkembangan Proyek (Progress Report) - Sukuk PT Makitech Sistem Indonesia (MSY 06 & 07)
Download Laporan PDFYth. Bapak/Ibu Investor,
Semoga Bapak/Ibu senantiasa dalam keadaan sehat dan segala aktivitasnya selalu diberkahi oleh Allah Ta'ala.
Melalui laporan ini, kami ingin menyampaikan pembaruan informasi mengenai perkembangan proyek MSY 06 & 07: Pengadaan 1 Unit Robot Palletizing pada PT Makitech Sistem Indonesia. Laporan ini merujuk pada pembaruan data teknis dan jadwal terbaru sebagai berikut:
---
1. Perkembangan Teknis Proyek

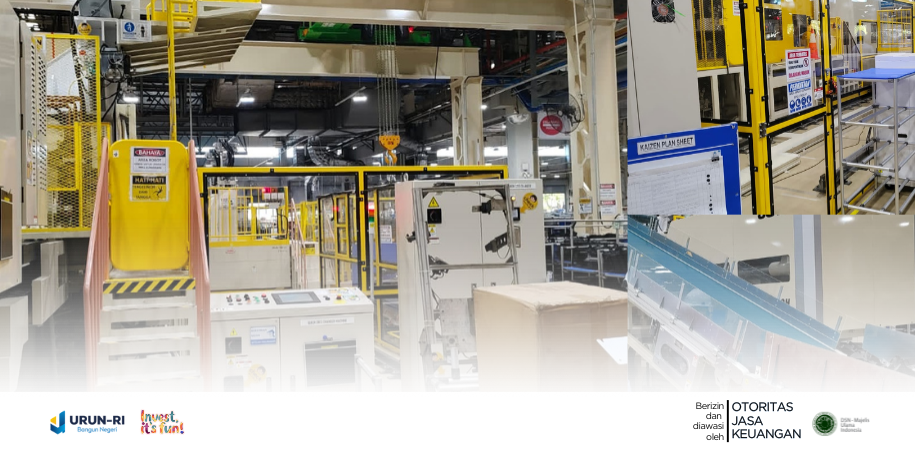

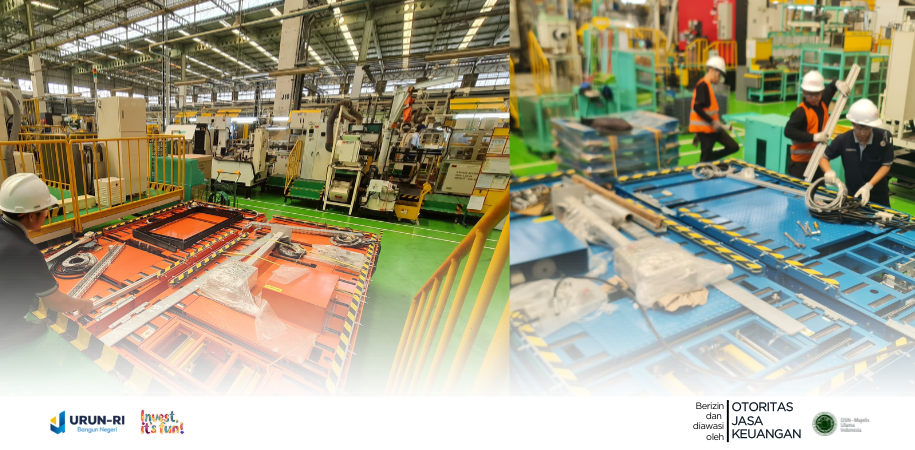

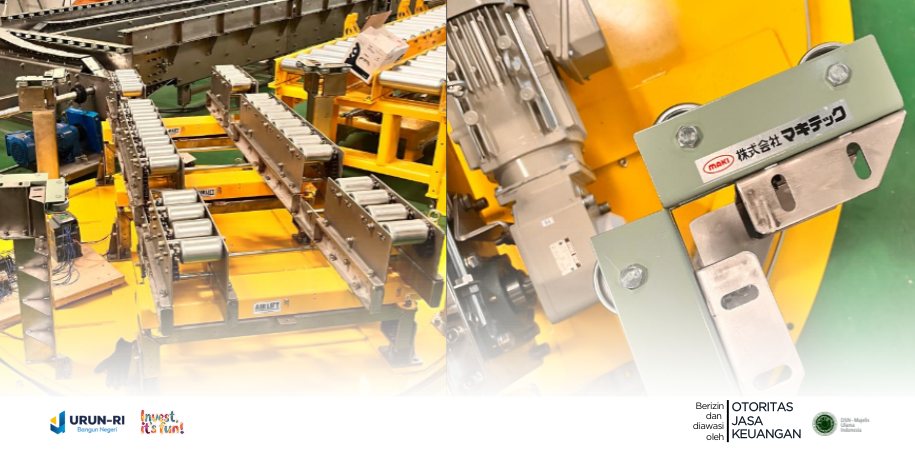

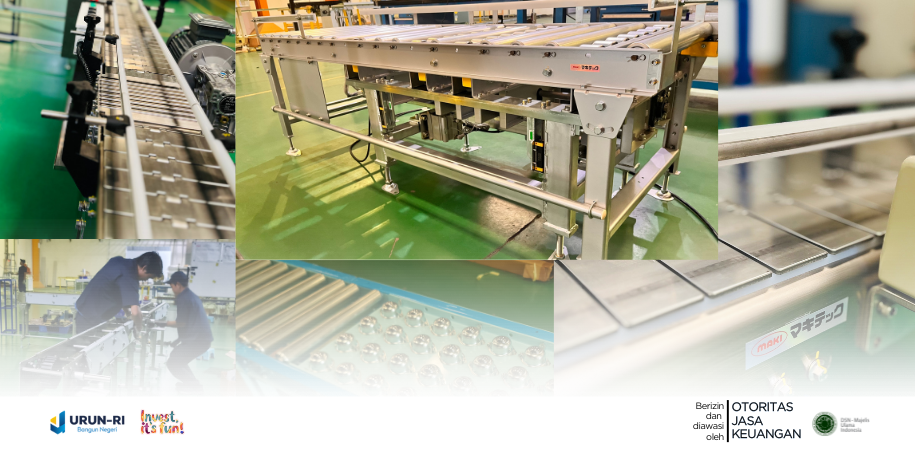

* Status Tahap 1 (Selesai): Segmen yang berhubungan dengan *Palletizing System Line 1* telah rampung, meliputi pembuatan dan instalasi *Curve Conveyor* (selesai 27 Desember 2025) serta pembuatan dan instalasi *Divider* (selesai 15 Maret 2026).
* Penyebab Keterlambatan: Terjadi penundaan penyelesaian proyek selama kurang lebih 1,5 bulan. Hal ini disebabkan oleh keterlambatan pada proses *drawing approval* serta waktu tunggu (*lead time*) komponen seperti *roller*, *powder coating*, komponen elektrikal, pneumatik, serta manufaktur lokal
* Status Saat Ini: Seluruh pengadaan komponen telah diselesaikan, dan saat ini tim sedang melanjutkan ke proses perakitan (*assembly*).---
2. Jadwal Milestone Terbaru (Estimasi April 2026)
Berdasarkan mitigasi pergeseran linimasa, berikut adalah target tahapan selanjutnya:
* Factory Acceptance Test (FAT): Dijadwalkan pada tanggal 8 & 9 April 2026.
* Pengiriman & Instalasi: Direncanakan pada rentang waktu 12 - 19 April 2026.
* Site Acceptance Test (SAT): Target penyelesaian pada 20 April 2026.---
3. Penyesuaian Jadwal Pembayaran kepada Investor
Sehubungan dengan adanya keterlambatan teknis tersebut, terdapat penyesuaian pada rencana jadwal pengembalian dana (amortisasi) dan bagi hasil guna menyesuaikan dengan waktu pembayaran dari pihak *customer* (30 hari setelah *invoice* diterbitkan).Ringkasan Perubahan Jadwal Akhir:
* MSY-06: Tenor disesuaikan menjadi 6 bulan 7 hari dengan target total pembayaran akhir pada Selasa, 16 Juni 2026.
* MSY-07: Tenor disesuaikan menjadi 5 bulan 24 hari kalender dengan target total pembayaran akhir pada Selasa, 16 Juni 2026.> Catatan Penting: Sesuai prosedur, dana akan ditransfer oleh Bank Kustodian langsung ke rekening Investor yang terdaftar paling lambat satu hari kerja sebelum tanggal distribusi.
Pihak Penerbit memohon maaf yang sebesar-besarnya atas keterlambatan ini dan berkomitmen penuh untuk menyelesaikan seluruh kewajiban kepada para investor. Kami akan terus memantau proses *assembly* hingga tahap pembayaran akhir terlaksana dengan baik.
Terima kasih atas pengertian, kesabaran, dan dukungan Bapak/Ibu sekalian.
Hormat kami,
Tim Manajemen Urun-RI
---------
Subject: Project Progress Report - Sukuk PT Makitech Sistem Indonesia (MSY 06 & 07)
Respected Investors,
May you always be in good health and may Allah Ta'ala bless all your activities and endeavors.
Through this report, we wish to provide an updated information regarding the progress of projects MSY 06 & 07: Procurement of 1 Unit Robot Palletizing at PT Makitech Sistem Indonesia. This report refers to the updated technical data and the latest schedule as follows:
---
1. Technical Project Development
* Step 1 Status (Completed): The segments related to the *Palletizing System Line 1* have been finished, including the fabrication and installation of the *Curve Conveyor* (completed on December 27, 2025) and the fabrication and installation of the *Divider* (completed on March 15, 2026).
* Reason for Delay: There has been a completion delay of approximately 1.5 months. This was caused by delays in the *drawing approval* process and the lead time for components such as *rollers*, *powder coating*, electrical and pneumatic components, as well as local manufacturing.
* Current Status: All part procurements have been completed, and the team is currently proceeding to the assembly process.---
2. Latest Milestone Schedule (April 2026 Estimate)
Based on the timeline shift mitigation, the following are the targets for the next stages:
* Factory Acceptance Test (FAT): Scheduled for April 8 & 9, 2026.
* Delivery & Installation: Planned for the period of April 12 - 19, 2026.
* Site Acceptance Test (SAT): Targeted for completion on April 20, 2026.---
3. Adjustment of Payment Schedule to Investors
Due to the aforementioned technical delays, there are adjustments to the planned capital repayment (amortization) and profit-sharing schedule to align with the payment timing from the customer (30 days after the invoice is issued).Summary of Final Schedule Changes:
* MSY-06: The tenor is adjusted to 6 months and 7 days, with a final payment target on Tuesday, June 16, 2026.
* MSY-07: The tenor is adjusted to 5 months and 24 calendar days, with a final payment target on Tuesday, June 16, 2026.> Important Note: In accordance with procedures, funds will be transferred by the Custodian Bank directly to the Investor's registered account no later than one business day before the distribution date.
The Issuer sincerely apologizes for this delay and remains fully committed to fulfilling all obligations to the investors. We will continue to monitor the assembly process until the final payment stage is successfully executed.
Thank you for your understanding, patience, and continued support.
Sincerely,
Urun-RI Management Team
Link Full Progress Report : https://drive.google.com/file/d/1HR7qWjusRe7y2TXZvixFmAQrB3544CxW/view?usp=sharing
-
LAPORAN PERKEMBANGAN PROYEK - 27 DESEMBER 2025
Assalaamu’alaikum Warahmatullaahi Wabarakaatuh,
Yth. Para Investor Sukuk MAKI-MSY06 dan MAKI-MSY07
Melalui laporan ini, Tim Monitoring Urun-RI menyampaikan pembaruan perkembangan proyek MAKI-MSY06 dan MAKI-MSY07, berdasarkan informasi resmi yang diterima dari Penerbit.
Alhamdulillaah,
Berdasarkan laporan Penerbit, pada Sabtu, 27 Desember 2025, telah dilaksanakan partial delivery serta proses instalasi untuk sebagian lingkup pekerjaan. Proses instalasi tersebut telah diselesaikan dan dilanjutkan dengan trial running tanpa produk, dengan hasil yang berjalan sesuai rencana.Proses instalasi untuk sebagian pekerjaan lanjutan di lokasi proyek dijadwalkan untuk dilanjutkan pada pekan ini. Penerbit menargetkan agar pelaksanaan instalasi dapat berjalan secara optimal dan lancar. Hingga laporan ini disampaikan, overall progress proyek telah mencapai sekitar 25%.
Sehubungan dengan proyek yang terdiri dari beberapa sub-pekerjaan, untuk sub lainnya saat ini masih berada dalam tahap proses pengadaan, penerimaan barang, serta detailing teknis. Dokumentasi pendukung turut dilampirkan, dan Tim Monitoring Urun-RI akan menyampaikan pembaruan berikutnya apabila terdapat perkembangan material selanjutnya.
Demikian pembaruan yang dapat kami sampaikan.
Terima kasih atas kepercayaan dan dukungan Bapak/Ibu Investor.Wassalaamu’alaikum Warahmatullaahi Wabarakaatuh.
Tim Monitoring Urun-RI
-------------------------------------------------------------------
السلام عليكم ورحمة الله وبركاته،
السادة مستثمري صكوك MAKI-MSY06 و MAKI-MSY07
من خلال هذا التقرير، يود فريق المتابعة في Urun-RI أن يوافيكم بآخر مستجدات مشروعي MAKI-MSY06 و MAKI-MSY07، وذلك استنادًا إلى المعلومات الرسمية الواردة من الجهة المصدِّرة.
الحمد لله،
وبحسب تقرير الجهة المصدِّرة، فقد تم يوم السبت 27 ديسمبر 2025 تنفيذ تسليم جزئي إلى جانب أعمال التركيب لجزء من نطاق الأعمال. وقد اكتملت أعمال التركيب، وتم إجراء تشغيل تجريبي دون منتج، وجاءت النتائج متوافقة مع الخطة المعتمدة.ومن المقرر استئناف أعمال التركيب لبعض الأعمال اللاحقة في موقع المشروع خلال هذا الأسبوع، مع استهداف الجهة المصدِّرة أن تسير أعمال التنفيذ بسلاسة وكفاءة. وحتى تاريخ هذا التقرير، فقد بلغ إجمالي نسبة التقدم في المشروع نحو 25%.
ونظرًا لأن المشروع يتكون من عدة أعمال فرعية، فإن الأعمال الأخرى لا تزال قيد إجراءات الشراء، واستلام المواد، وأعمال التفصيل الفني. وقد أُرفقت الوثائق الداعمة، وسيقوم فريق المتابعة في Urun-RI بإطلاع السادة المستثمرين على أي مستجدات جوهرية فور توفرها.
هذا ما تيسر إبلاغه في الوقت الراهن.
نشكر لكم ثقتكم ودعمكم المستمر.والسلام عليكم ورحمة الله وبركاته،
فريق المتابعة – Urun-RI
-
PENGIKATAN JAMINAN & INFORMASI JADWAL PEMBAYARAN SUKUK MAKI-MSY06 - 09 DESEMBER 2025
Assalamualaikum Warahmatullah Wabarakatuh
Yth. Para Investor Sukuk MAKI-MSY06
Semoga Bapak/Ibu senantiasa berada dalam limpahan rahmat dan keberkahan Allah Subhanahu wa Ta’ala.Alhamdulillaah,
Pengikatan jaminan untuk Sukuk MAKI-MSY06 telah dilaksanakan pada 09 Desember 2025. Pelaksanaan pengikatan jaminan ini merupakan bagian dari pemenuhan struktur mitigasi risiko serta perlindungan kepentingan Investor sebagaimana telah ditetapkan dalam dokumen penerbitan Sukuk.Selanjutnya, dana Sukuk telah diserahkan kepada Penerbit pada 09 Desember 2025. Adapun jadwal pembayaran telah disampaikan dan dapat dilihat pada lampiran yang disertakan dalam laporan ini.
Demikian pembaruan yang dapat kami sampaikan.
Terima kasih atas kepercayaan dan dukungan Bapak/Ibu Investor.Wassalaamu’alaikum Warahmatullaahi Wabarakaatuh.
Tim Monitoring Urun-RI
